Updates in December 2025

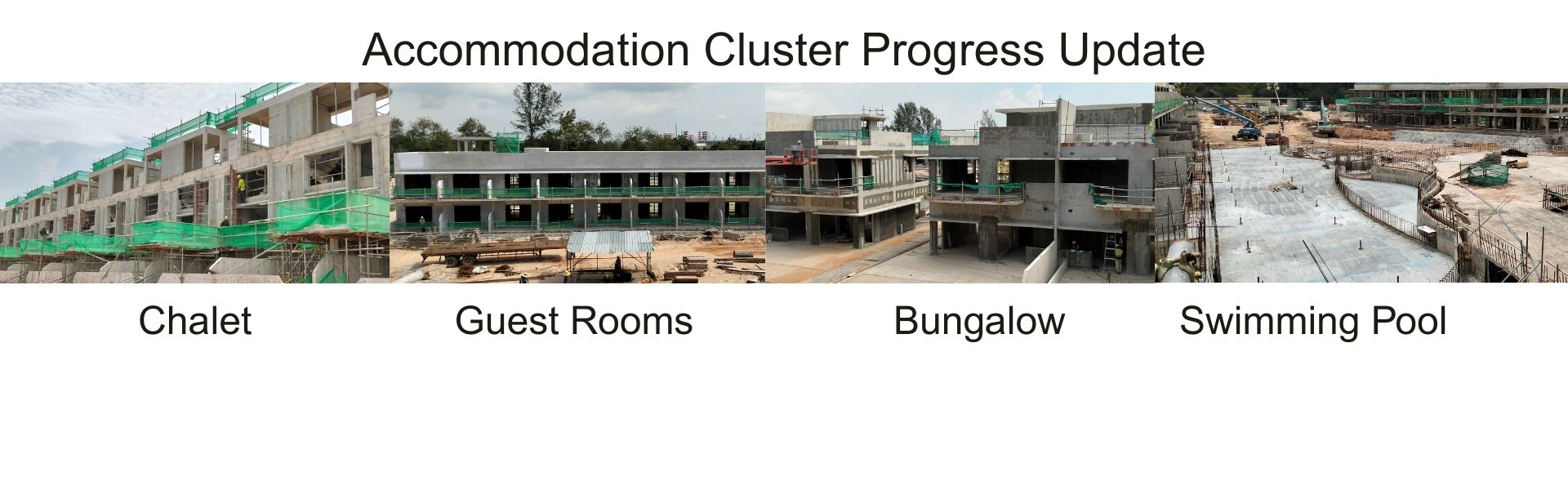

Accommodation Cluster Progress Update

Steady progress continues across the entire Accommodation Cluster, with significant advancements in all lodging types and supporting facilities. Ongoing works remain focused on delivering high-quality construction that meets both the design intent and operational needs.

  • Chalets (North):
    • Precast wall installation completed.
    • Structural works completed.
    • Internal wall construction works are ongoing.
    • External plastering works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Chalets (West):
    • Precast wall installation completed.
    • Structural works completed.
    • Internal wall construction works are ongoing.
    • External plastering works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Bungalows (Pet):
    • Internal wall construction works are ongoing.
    • Plastering works are ongoing.
    • Railing installation works are ongoing
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Bungalows (South):
    • Wall works are in progress.
    • 2nd floor slab construction works are ongoing.
  • Guest Rooms:
    • Plastering works are ongoing.
    • Mechanical/ Electrical/ Plumbing works in progress.
  • Villa (East):
    • Wall works are in progress.
    • Plastering works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Villa (West):
    • Wall works are in progress.
    • Plastering works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Swimming Pool:
    • Structural works are ongoing.
    • Plumbing works are ongoing.
  • Accommodation Admin Building:
    • Plastering works in progress.
    • Perimeter drain construction works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Housekeeping Building:
    • Plastering works in progress.
    • Mechanical/ Electrical/ Plumbing works are ongoing.

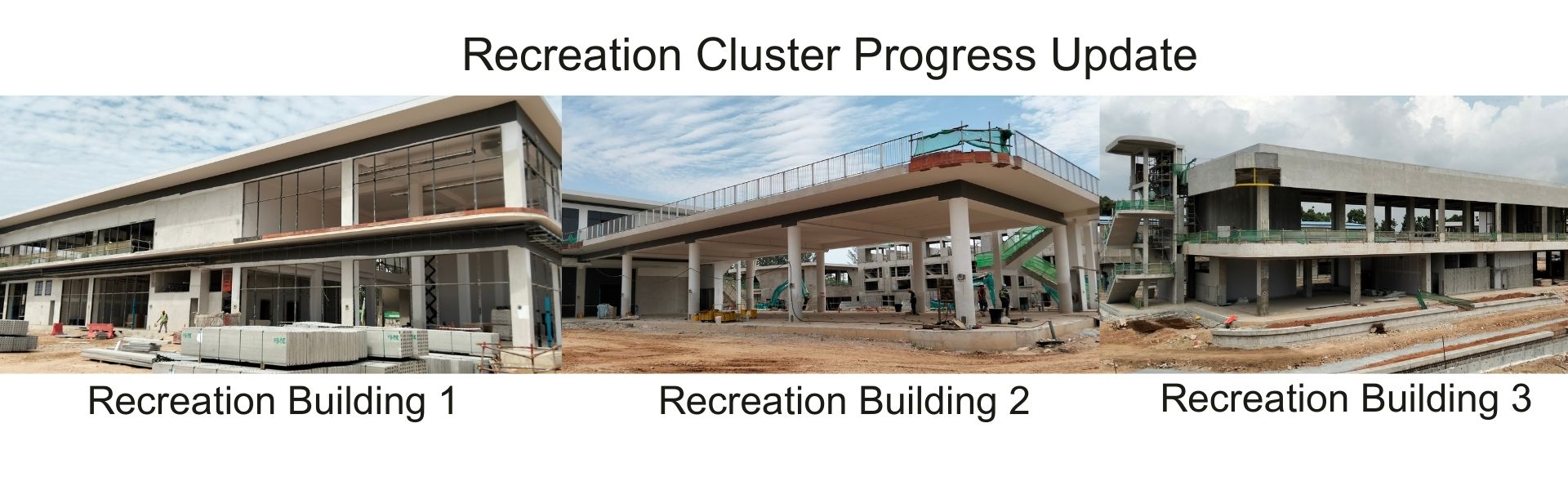

Recreation Cluster Progress Update

The Recreation Cluster is progressing strongly, with finishing works and detailed installations now at the forefront. It is poised to become a signature dining destination, blending striking visuals with a unique coastal atmosphere.

  • Recreational Buildings 1:
    • Plastering works are ongoing.
    • Railing installation works are in progress.
    • Façade installation works are in progress.
    • Perimeter drain construction works are ongoing.
    • Lift installation works are in progress.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Recreational Buildings 2:
    • Plastering works are ongoing.
    • Railing installation works are in progress.
    • Façade installation works are in progress.
    • Perimeter drain construction works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Recreational Building 3:
    • Wall works are in progress.
    • Plastering works in progress.
    • Perimeter drain construction works are ongoing.
    • Lift installation works are in progress.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Gazebo Units:
    • Plastering works are ongoing.
    • Façade installation works are in progress.
    • Perimeter drain construction works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.

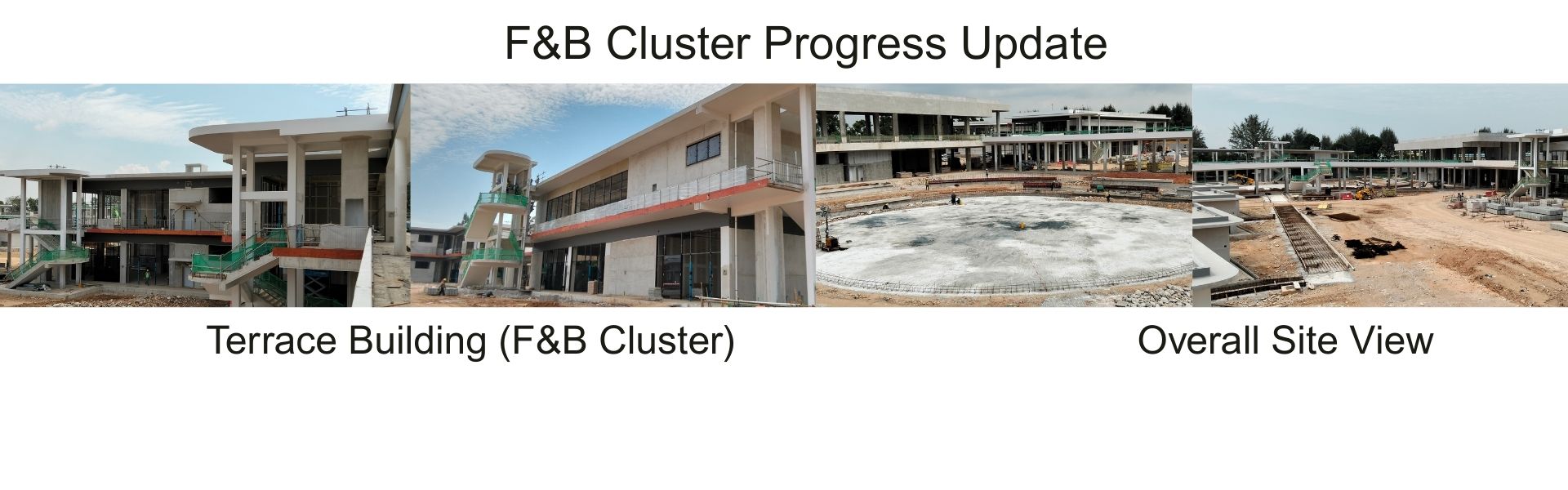

F&B Cluster Progress Update

Steady progress at the Terrace Building is propelling the F&B Cluster toward becoming a standout dining destination, showcasing bold design elements and an energetic coastal ambience.

  • Plastering works are ongoing.
  • Railing installation works are in progress.
  • Façade installation works are in progress.
  • Perimeter drain construction works are ongoing.
  • Lift installation works are in progress.
  • Mechanical/ Electrical/ Plumbing works are ongoing.



Substation & Bincentre

All structural and architectural works have been completed. The team is now awaiting the delivery of equipment and other related electrical and mechanical items.



General Areas Progress Update

Construction is ongoing to establish seamless connectivity throughout the development. Shared infrastructure components are being built in tandem with the main clusters to support integrated operations and enhance overall accessibility.

  • Ground levelling works for car parks and internal roads are actively in progress.
  • Structural works for the linkway connecting Recreational Building 3 to the F&B Cluster are in progress.
  • Amphitheatre works are in progress.



Overall Progress

All clusters are advancing according to the project schedule, with structural works close to completion and current efforts concentrated on architectural finishes, interior fit-outs, and MEP coordination. Key authority approvals such as drainage and road permits are in progress, backed by efficient coordination. The project has also received its Interim Green Mark certification. Overall, progress remains strong on both construction and regulatory fronts.
