Updates in January 2026

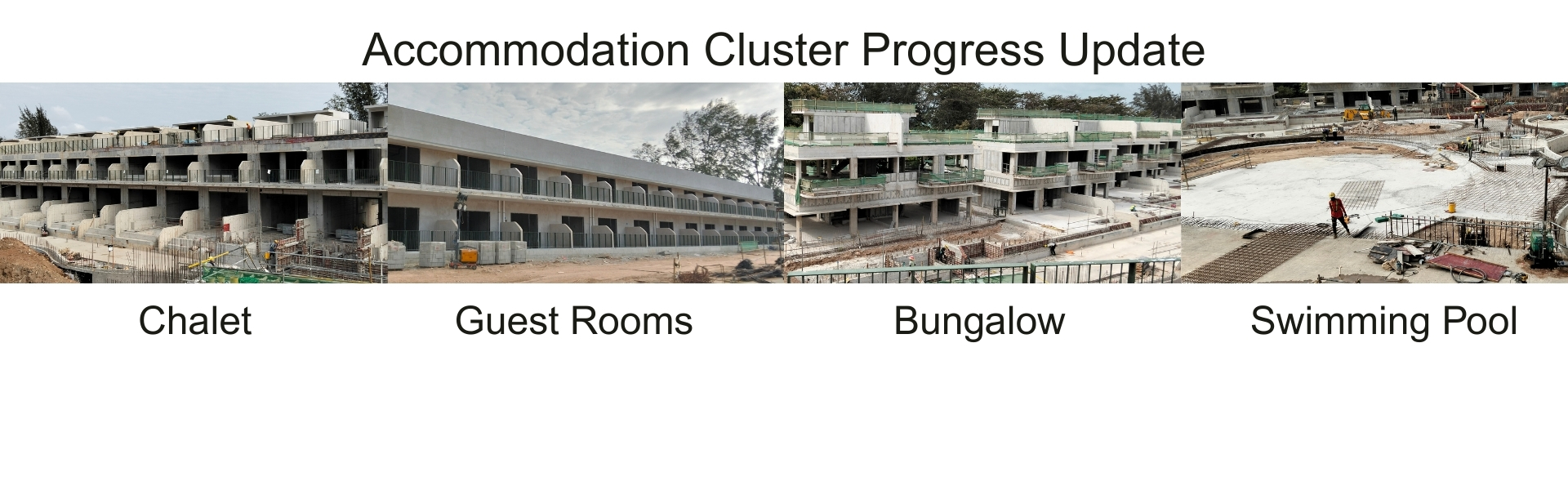

Accommodation Cluster Progress Update

Progress across the Accommodation Cluster remains strong, with notable advancements in all accommodation types and supporting facilities. Current efforts are concentrated on delivering high-quality construction that fully aligns with the project’s design vision and operational objectives.

  • Chalets (North):
    • Internal wall construction works completed.
    • External plastering works completed.
    • Internal flooring works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Chalets (West):
    • Internal wall construction works completed.
    • External plastering works completed.
    • Internal flooring works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Bungalows (Pet):
    • Internal wall construction works completed.
    • Plastering works are completed.
    • Railing installation works are ongoing.
    • Internal flooring works are ongoing.
    • Window installation works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Bungalows (South):
    • Wall works are in progress.
    • 2nd floor slab construction works completed.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Guest Rooms:
    • Wall works are in progress.
    • Plastering works are ongoing.
    • Railing installation works are ongoing.
    • Internal flooring works are ongoing.
    • Window installation works are ongoing.
    • Mechanical/ Electrical/ Plumbing works in progress.
  • Villa (East & West):
    • Wall works are in progress.
    • Plastering works are ongoing.
    • Internal flooring works are ongoing.
    • Window installation works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Swimming Pool:
    • Structural works are ongoing.
    • Plumbing works are ongoing.
  • Accommodation Admin Building:
    • Plastering works in progress.
    • Perimeter drain construction works are ongoing.
    • Internal flooring works are ongoing.
    • Window installation works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Housekeeping Building:
    • Plastering works in progress.
    • Internal flooring works are ongoing.
    • Window installation works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.

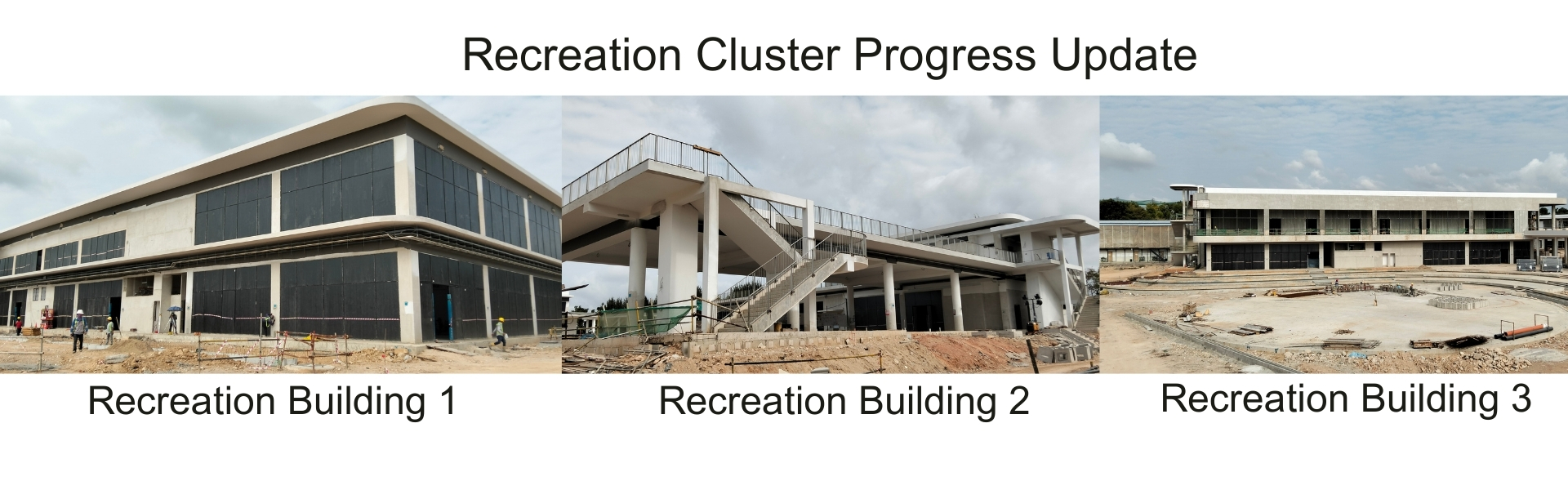

Recreation Cluster Progress Update

The Recreation Cluster is advancing well, with finishing works and detailed installations taking centre stage. Positioned to become a landmark dining destination, it will showcase striking design elements while capturing the distinctive charm of its coastal setting.

  • Recreational Buildings 1:
    • Plastering works are completed.
    • Railing installation works are in progress.
    • Internal flooring works are ongoing.
    • Window installation works are ongoing.
    • Perimeter drain construction works are ongoing.
    • Lift installation works are in progress.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Recreational Buildings 2:
    • Plastering works are completed.
    • Railing installation works are in progress.
    • Internal flooring works are ongoing.
    • Window installation works are ongoing.
    • Perimeter drain construction works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Recreational Building 3:
    • Wall works are in progress.
    • Plastering works in progress.
    • Perimeter drain construction works are ongoing.
    • Lift installation works are in progress.
    • Mechanical/ Electrical/ Plumbing works are ongoing.
  • Gazebo Units:
    • Plastering works completed.
    • Wall skim coat and painting works are ongoing
    • Window installation works are in progress.
    • Perimeter drain construction works are ongoing.
    • Mechanical/ Electrical/ Plumbing works are ongoing.

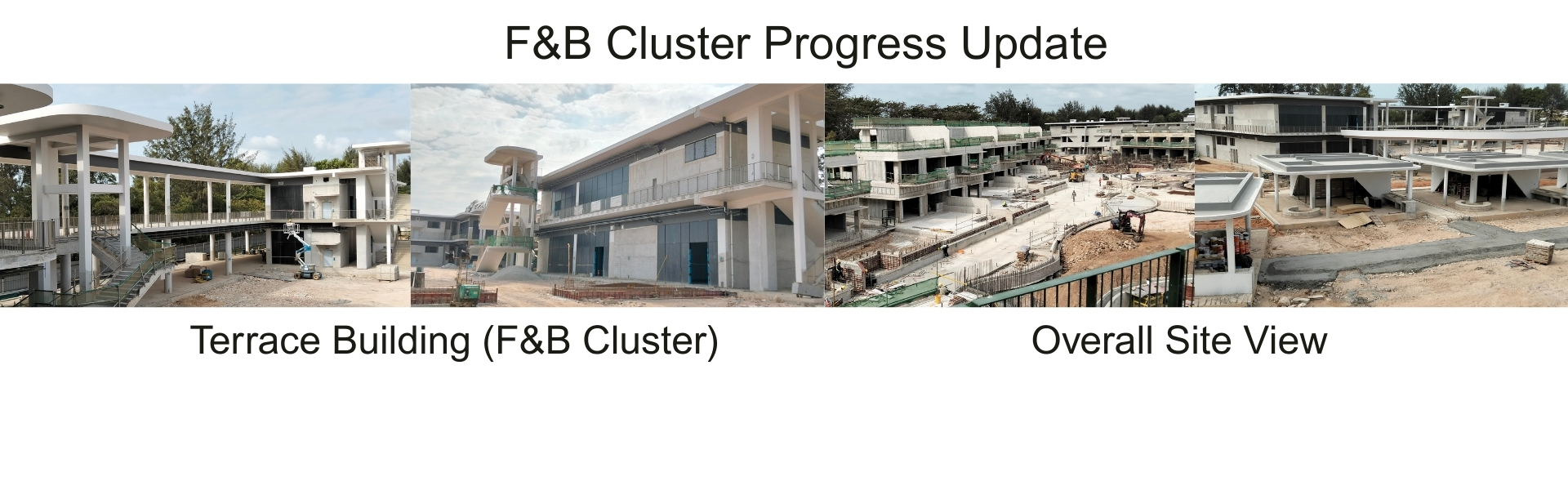

F&B Cluster Progress Update

Steady progress at the Terrace Building continues to drive the F&B Cluster forward, with bold design features and vibrant coastal elements shaping its identity as a standout dining destination.

    • Plastering works are completed.
    • Railing installation works are in progress.
    • Internal flooring works are ongoing.
    • Window installation works are ongoing.
    • Perimeter drain construction works are ongoing.
    • Lift installation works are in progress.
    • Mechanical/ Electrical/ Plumbing works are ongoing.



Substation & Bincentre

All structural and architectural works have been completed. The team is now awaiting the delivery of equipment and other related electrical and mechanical items.



General Areas Progress Update

Connectivity works are progressing well, with car parks, internal roads, the linkway, and amphitheatre construction advancing in tandem. These shared infrastructure components are on track to enhance accessibility and support integrated operations across the development.



Overall Progress

Project clusters remain on schedule, with structural works nearly complete and focus shifting to finishes and MEP coordination. Regulatory approvals are progressing smoothly, and the Interim Green Mark certification has been secured, reinforcing strong performance on both construction and compliance fronts.
