Updates in Oct 2026

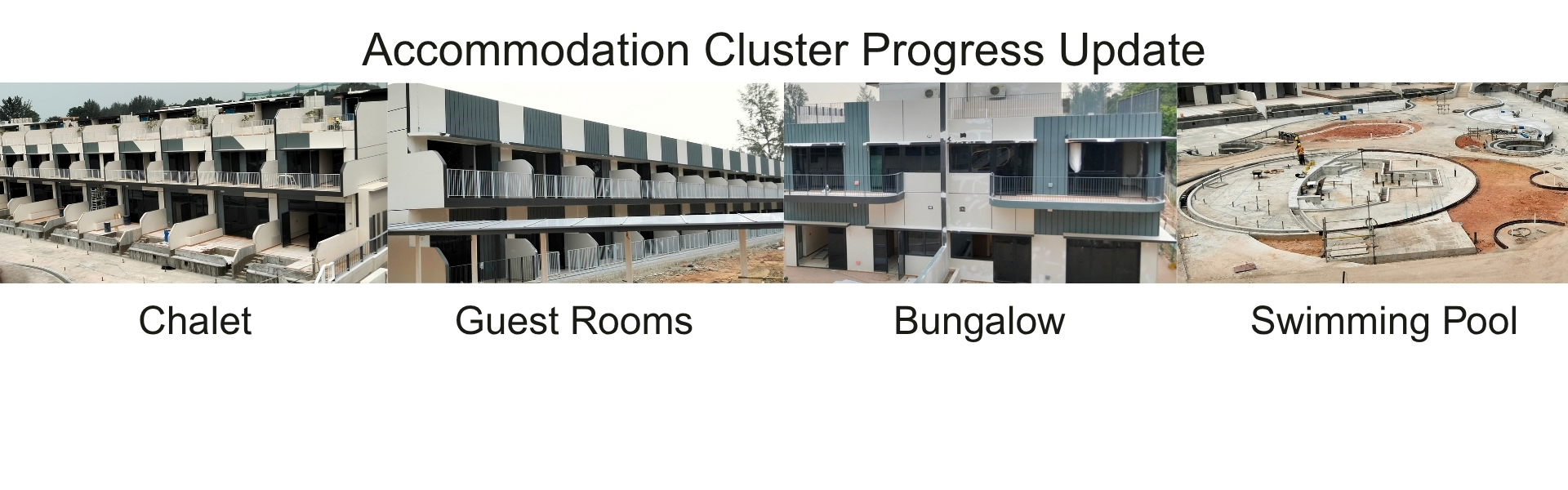

Accommodation Cluster Progress Update

The Accommodation Cluster has progressed into the final stage of construction, with the majority of architectural works substantially completed. Current activities are mainly focused on finalising architectural finishes, completing outstanding MEP works, and preparing the accommodation facilities for the installation and placement of internal furniture and fittings.

Chalets (North & West)

  • Final architectural finishing works are ongoing.
  • Final touch-up, rectification, and finishing works are being carried out progressively.
  • Internal areas are being prepared for the installation of furniture and fittings.
  • Final MEP installation, testing, and commissioning works are ongoing.

Bungalows (Pet & South)

  • Final architectural finishing and rectification works are ongoing.
  • Internal spaces are being prepared for furniture and fittings installation.
  • Final MEP works, testing, and coordination are progressing.

Guest Rooms

  • Final architectural finishing works are ongoing.
  • Internal areas are being progressively prepared for furniture installation and final fit-out.
  • Outstanding MEP installation, testing, and commissioning works are ongoing.

Villas (East & West)

  • Architectural finishing works are substantially completed, with final finishing and rectification works ongoing.
  • Internal spaces are being prepared for furniture and fittings installation.
  • Final MEP installation, testing, and commissioning works are progressing.

Swimming Pool

  • Waterproofing works are ongoing.
  • Tile laying works are in progress.
  • Plumbing, filtration, and associated MEP installation works are ongoing.

Accommodation Administration Building

  • Final architectural finishing works are ongoing.
  • Internal fit-out works are progressing well.
  • MEP installation, testing, and commissioning preparation works are ongoing.

Housekeeping Building

  • Architectural finishing works are ongoing.
  • Internal fit-out and finishing works are progressing.

MEP installation, testing, and commissioning works are continuing.

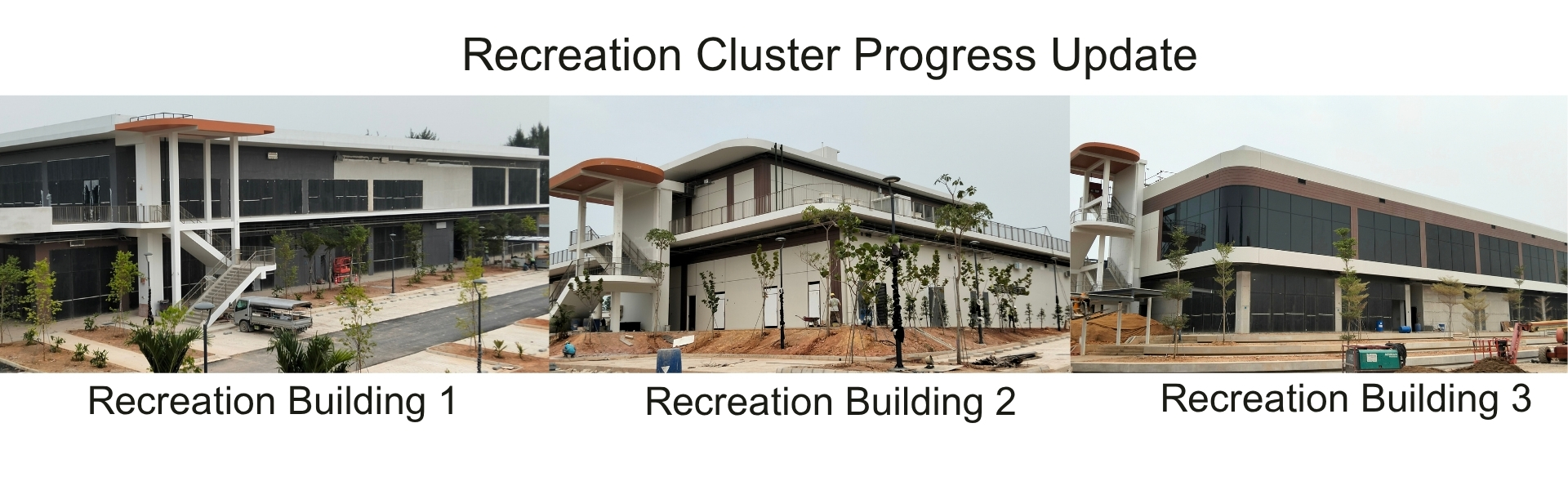

Recreation Cluster Progress Update

The Recreation Cluster has entered the final stage of construction, with the primary focus on completing architectural finishes, carrying out final rectification works, and preparing the buildings for internal furniture and fittings installation.

Recreational Buildings 1, 2 & 3

  • Final architectural finishing and rectification works are ongoing.
  • Internal areas are being progressively prepared for furniture and fittings installation.
  • Final MEP installation, testing, and commissioning works are ongoing.
  • Outstanding building services coordination and finishing works are being addressed progressively.

Gazebo Units

  • Architectural finishing works are substantially completed, with final touch-up and rectification works ongoing.
  • Internal areas are being prepared for final fit-out.
  • Final MEP installation and testing works are ongoing.

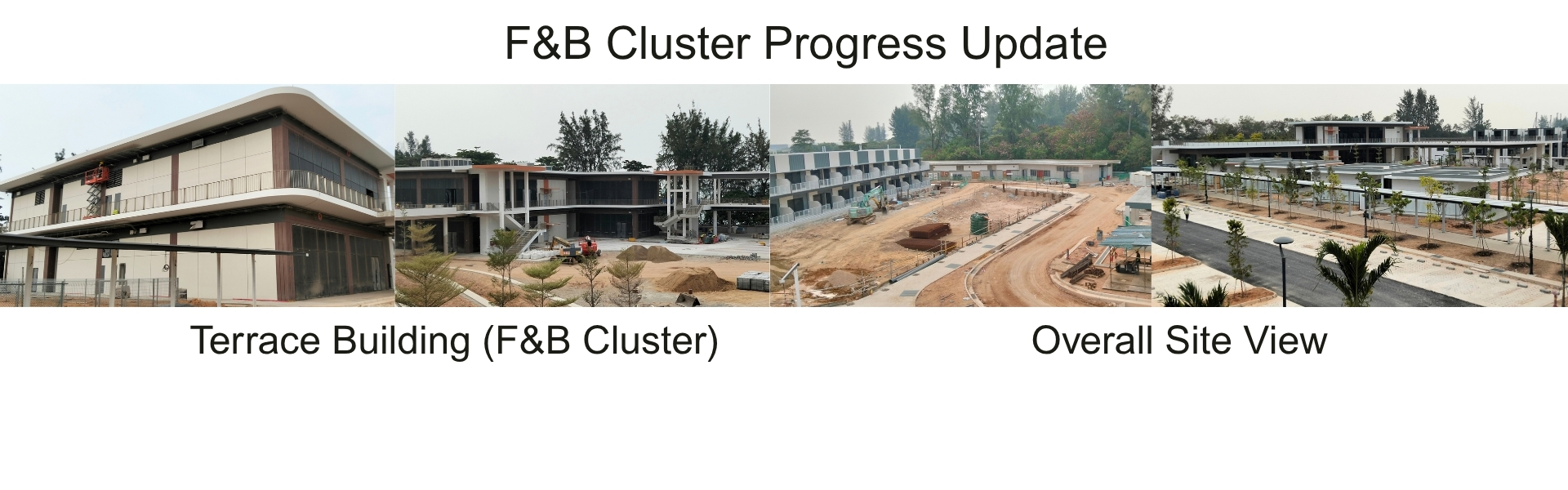

F&B Cluster Progress Update

The F&B Cluster, including the Terrace Building, is also progressing into the final construction and fit-out stage. The main focus is on completing architectural finishes, finalising building services, and preparing the internal spaces for furniture and equipment installation.

  • Final architectural finishing and rectification works are ongoing.
  • Internal areas are being prepared for furniture, fittings, and equipment installation.
  • Final MEP installation, testing, and commissioning works are ongoing.
  • Outstanding building services coordination and architectural finishing works are being progressively completed.
  • External works surrounding the building are continuing in parallel.



Substation & Bin Centre

The Substation and Bin Centre construction works have been completed.

The project is currently pending the installation of the relevant equipment by the respective authorities/service providers, followed by the necessary inspections, testing, authority clearances, and related commissioning requirements.



General Areas Progress Update

External and common infrastructure works continue to progress steadily, with the project now focusing on completing the roads, car parks, landscaping, entrance facilities, drainage, and external services.

  • Internal road construction works are ongoing.
  • Car park construction, paving, and associated finishing works are progressing steadily.
  • Main entrance construction works are ongoing.
  • Guard house construction works have been completed.
  • External drainage and utility infrastructure works are ongoing.
  • Linkway and pedestrian connectivity works continue to progress.
  • Landscaping works, including hardscape and softscape installations, are progressing steadily.
  • External MEP services and utility connections are being carried out concurrently with the road and infrastructure works.
  • Final coordination between external works, landscaping, MEP services, and road infrastructure is ongoing.


Overall Progress

The project has progressed into the final stages of construction, with all major structural works completed across the development. Current activities are predominantly focused on completing final architectural finishes, outstanding MEP installations, testing and commissioning, internal fit-out, and preparation of the buildings for furniture, fittings, and equipment installation.

Across the Accommodation, Recreation, and F&B Clusters, architectural works are being progressively finalised, while final MEP works and associated testing and commissioning activities continue concurrently. The project is also progressing with the necessary preparations for internal furniture and fittings installation.

External works remain a key focus, with internal roads, car parks, the main entrance, drainage, utility infrastructure, linkways, and landscaping works progressing in parallel. The Guard House construction has been completed, while the Substation and Bin Centre are completed and pending the relevant authority/service-provider installations and subsequent clearances.

Overall, the project is moving progressively towards the final completion, testing and commissioning, authority clearance, and operational readiness stages, with the remaining works primarily comprising architectural finishes, MEP completion, external infrastructure, landscaping, furniture/fittings installation, testing and commissioning, and statutory clearances.
