Updates in Aug 2026

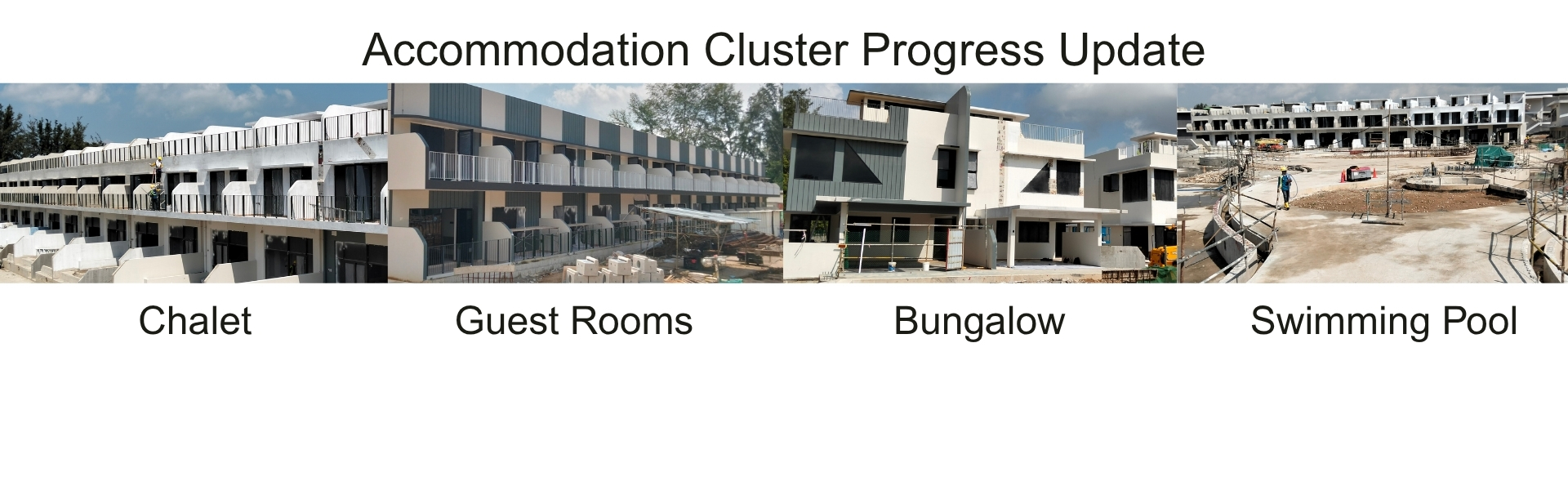

Accommodation Cluster Progress Update

The Accommodation Cluster continues to make steady progress, with all major structural works completed. Current activities are primarily focused on architectural finishes, MEP installations, and external infrastructure works in preparation for the next phase of the project.

Chalets (North & West)

  • Architectural finishing works, including flooring, painting, ceiling, and internal fit-out works, are ongoing.
  • Window and door installation works are nearing completion.
  • MEP installation, testing, and coordination works are ongoing.

Bungalows (Pet & South)

  • Architectural finishing works, including flooring, painting, ceilings, and joinery installations, are progressing well.
  • Railing and glazing installation works are ongoing.
  • MEP installation, testing, and coordination works are progressing steadily.

Guest Rooms

  • Architectural finishing works are ongoing.
  • Internal flooring, painting, and ceiling works are in progress.
  • MEP installation works are continuing across all levels.

Villas (East & West)

  • Architectural finishing works are nearing completion.
  • Internal finishes, glazing, and painting works are nearing completion.
  • MEP installation and coordination works are ongoing.
  • Swimming pool construction works are substantially completed, while pool-related MEP installation works are in progress.

Swimming Pool

  • Waterproofing works are ongoing.
  • Tile laying works are in progress.
  • Plumbing, filtration, and associated MEP installation works are ongoing.

Accommodation Administration Building

  • Architectural finishing works are ongoing.
  • Internal fit-out works are progressing well.
  • MEP installation, testing, and commissioning preparation works are ongoing.

Housekeeping Building

  • Architectural finishing works are progressing steadily.
  • Internal fit-out and finishing works are ongoing.
  • MEP installation works are continuing.

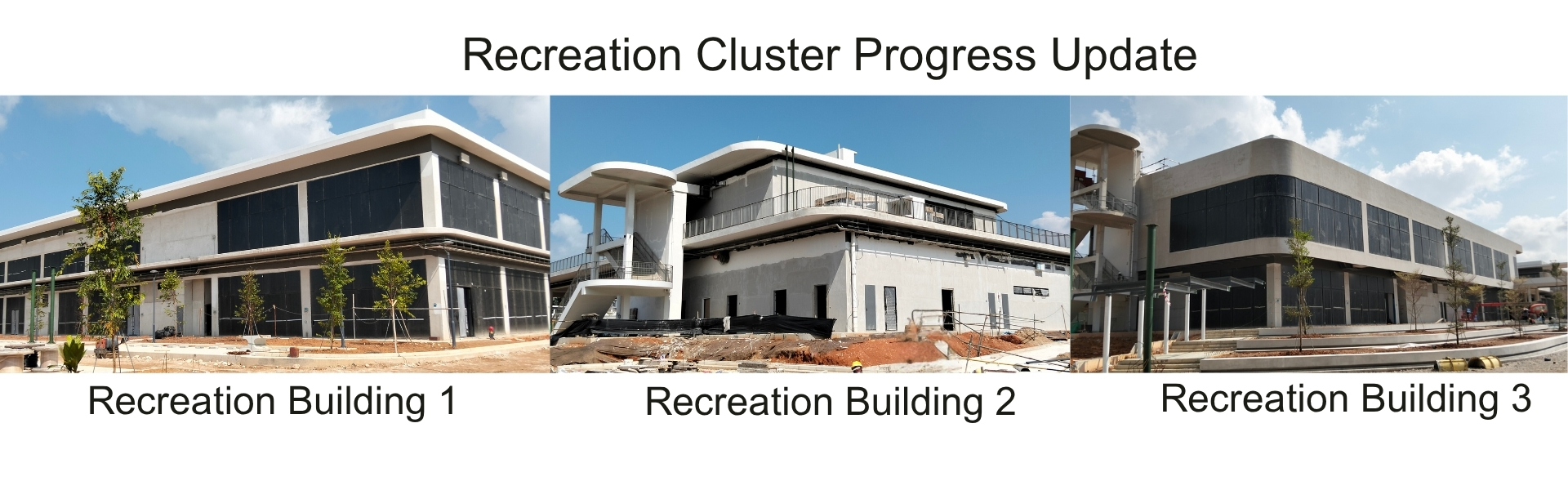

Recreation Cluster Progress Update

The Recreation Cluster has entered the final stages of construction, with primary activities focused on architectural finishes, MEP installations, and external infrastructure works.

Recreational Buildings 1, 2 & 3

  • Architectural finishing works, including flooring, painting, ceiling, glazing, and railing installations, are ongoing.
  • Lift installation and associated testing works are progressing.
  • MEP installation, testing, and coordination works are ongoing.

Gazebo Units

  • Architectural finishing and painting works are nearing completion.
  • Internal fit-out works are progressing.
  • MEP installation, testing, and commissioning preparation works are ongoing.

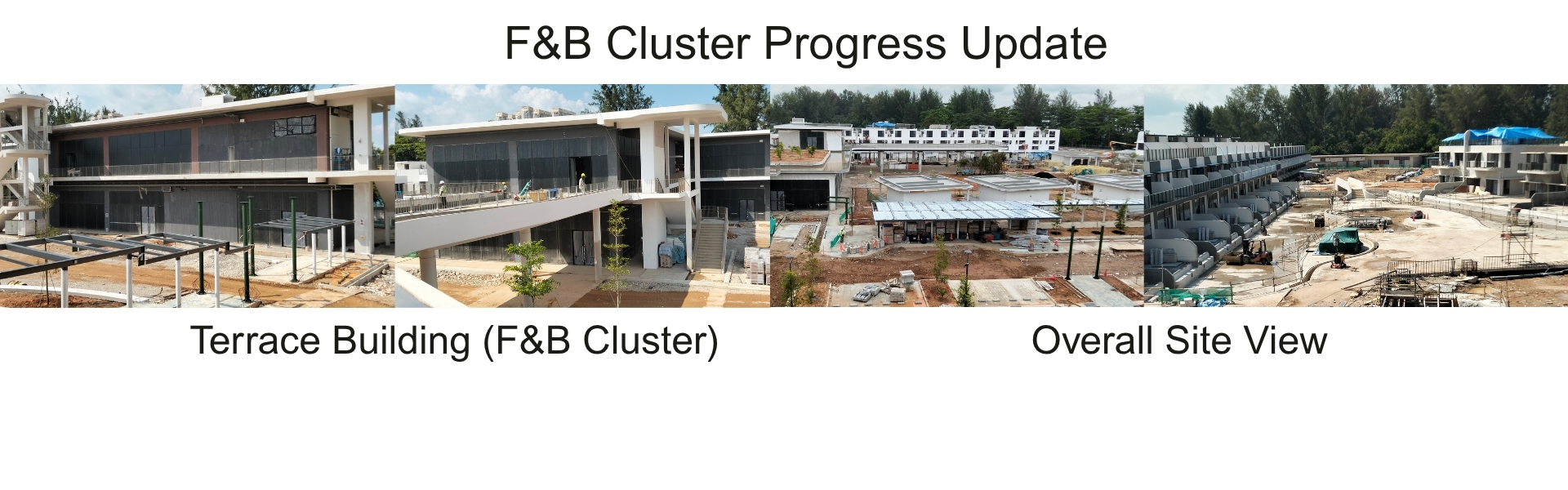

F&B Cluster Progress Update

The Terrace Building continues to progress steadily, with works concentrated on architectural finishes and building services installations.

  • Architectural finishing works, including flooring, painting, ceiling, and glazing installations, are ongoing.
  • Lift installation works are nearing completion.
  • MEP installation, testing, and coordination works are progressing steadily.

External infrastructure and surrounding works are ongoing.



Substation & Bin Centre

All structural and architectural works have been completed.

Installation of electrical and mechanical equipment is progressing, with testing and commissioning activities being carried out in phases.



General Areas Progress Update

Construction activities across the common infrastructure areas continue to progress well, with significant advancement in external works supporting the overall site development.

  • Internal road construction works are ongoing.
  • Car park construction and paving works are progressing steadily.
  • Main entrance construction works are ongoing.
  • Guard house construction works are progressing well.
  • External drainage and utility infrastructure works are ongoing.
  • Linkway and pedestrian connectivity works continue to advance.
  • Landscaping works, including both hardscape and softscape installations, are progressing steadily.
  • External MEP services and utility connections are being carried out concurrently with the road and infrastructure works.



Overall Progress

The project continues to progress in accordance with the overall construction programme. With all major structural works completed, the project's primary focus has shifted towards architectural finishing works, MEP installations, testing and commissioning preparation, and external infrastructure development.

Key site activities currently include architectural finishes across all building clusters, waterproofing and tile installation for the swimming pool, construction of the main entrance and guard house, road and car park development, utility infrastructure, and landscaping works. These activities are progressing concurrently to support the project's timely completion and operational readiness.

Regulatory submissions and authority coordination continue to progress as planned. The successful achievement of the Interim Green Mark Certification further demonstrates the project's commitment to sustainability, quality, and regulatory compliance.
