Updates in April 2026
.png)
_2.jpg)

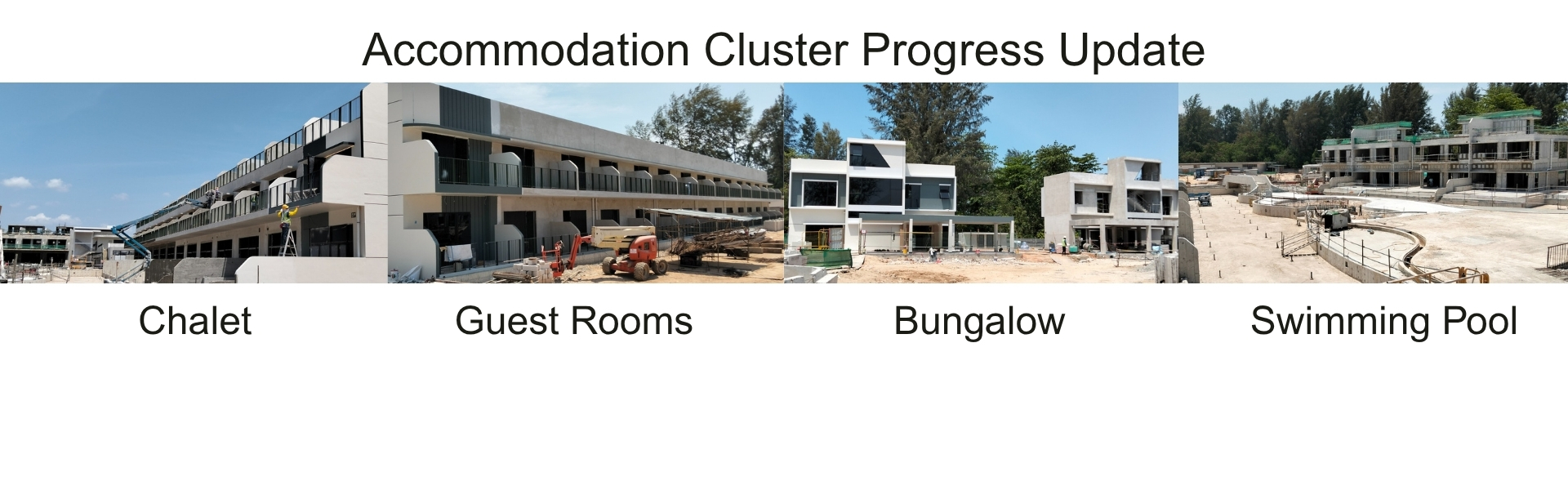

Accommodation Cluster Progress Update
Works within the Accommodation Cluster are progressing well, with structural works largely completed across all buildings. Current activities are focused on architectural finishes, MEP installations, and final detailing to meet design and operational requirements.
- Chalets (North & West):
- Structural, internal wall, and external plastering works have been completed.
- Ongoing works include internal flooring, window installation, and MEP services.
- Bungalows (Pet):
- Structural and wall construction works have been completed.
- Plastering works are completed.
- Railing installation, window installation, and internal flooring works are in progress.
- MEP works are ongoing.
- Bungalows (South):
- Structural works have been completed.
- Architectural finishing works, including wall treatments and plastering, are ongoing.
- Window installation, railing installation, and internal flooring works are in progress.
- MEP works are ongoing.
- Guest Rooms:
- Structural works have been completed.
- Plastering, window installation, and railing works are ongoing.
- Internal flooring works are in progress.
- MEP works are ongoing.
- Villas (East & West):
- Structural works have been completed.
- Plastering, window installation, and internal flooring works are in progress.
- MEP works are ongoing.
- Swimming Pool:
- Structural works have been completed.
- Waterproofing, finishing, and plumbing works are currently in progress.
- Accommodation Admin Building:
- Structural works have been completed.
- Ongoing works include plastering, window installation, internal flooring, and perimeter drainage.
- MEP works are ongoing.
- Housekeeping Building:
- Structural works have been completed.
- Plastering, window installation, and internal flooring works are ongoing.
- MEP works are ongoing.
_0.jpg)

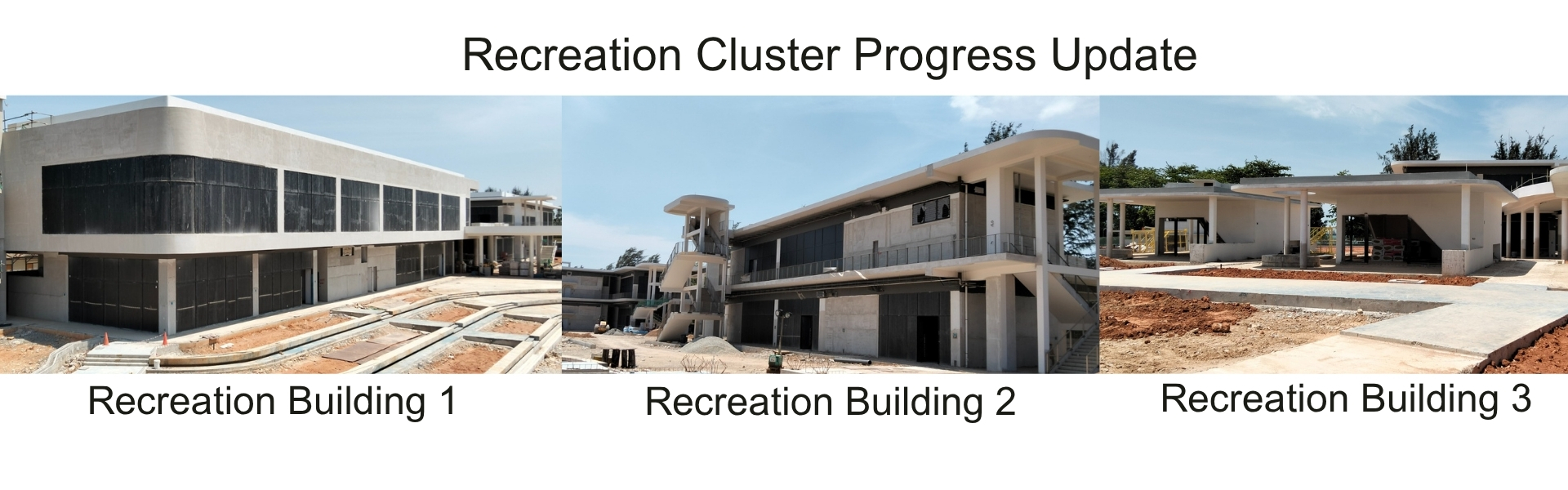

Recreation Cluster Progress Update
The Recreation Cluster has moved into the architectural finishing and MEP installation stage, with emphasis on coordination and detailed works.
- Recreational Buildings 1 & 2:
- Structural and plastering works have been completed.
- Internal flooring, window installation, and railing works are ongoing.
- Lift installation (where applicable) is in progress.
- Perimeter drainage works are ongoing.
- MEP works are ongoing.
- Recreational Building 3:
- Structural works have been completed.
- Plastering and architectural finishing works are in progress.
- Lift installation works are ongoing.
- Perimeter drainage works are ongoing.
- MEP works are ongoing.
- Gazebo Units:
- Structural and plastering works have been completed.
- Wall skim coating and painting works are ongoing.
- Window installation works are in progress.
- Perimeter drainage works are ongoing.
- MEP works are ongoing.
_0.jpg)

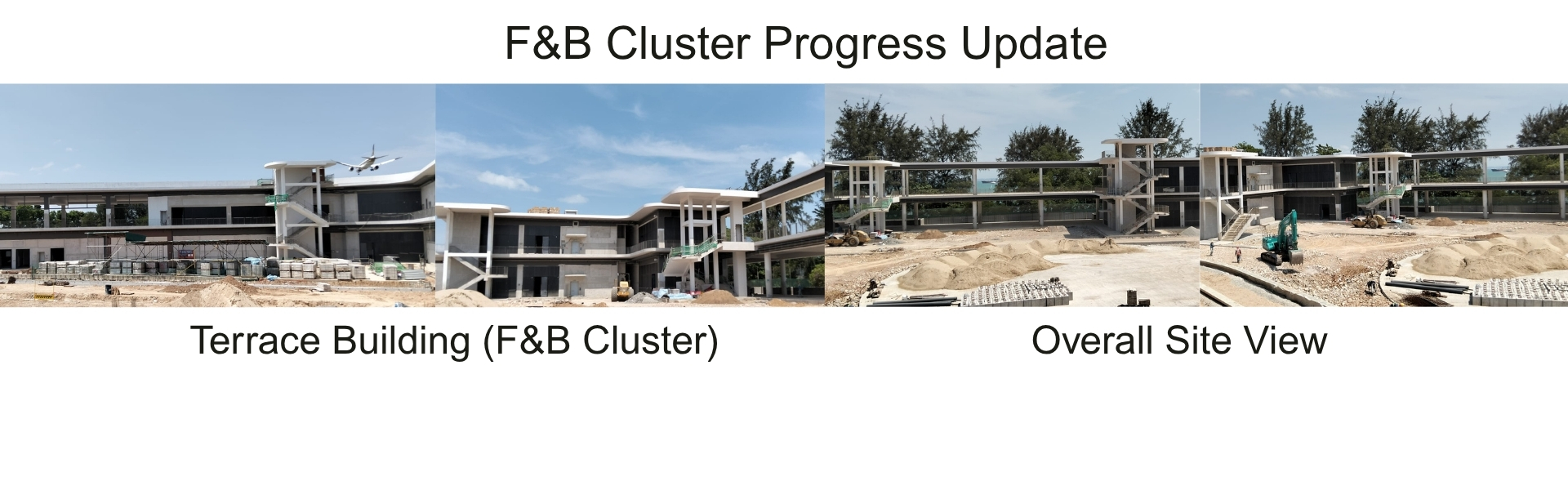

F&B Cluster Progress Update
The F&B Cluster (Terrace Building) has advanced into the finishing and services installation phase, with key architectural elements being progressively completed.
- Structural and plastering works have been completed.
- Internal flooring, window installation, and railing works are ongoing.
- Lift installation works are in progress.
- Perimeter drainage works are ongoing.
- MEP works are ongoing.
Substation & Bin Centre
All structural and architectural works have been completed.
The team is currently coordinating the delivery, installation, and subsequent testing of electrical and mechanical equipment.
General Areas Progress Update
External infrastructure and connectivity works are progressing steadily, supporting overall site integration and accessibility.
- Construction of internal roads and car parks is ongoing.
- Drainage and other external infrastructure works are in progress.
- Linkways and amphitheatre construction works are ongoing.
- Coordination of MEP services with external works is actively underway.
Overall Progress
The project continues to progress as planned, with structural works substantially completed across all clusters. Current focus has shifted towards architectural finishes, MEP installations, and external works, including roads and car parks.
Regulatory approvals are progressing smoothly, and the project has successfully obtained the Interim Green Mark certification, demonstrating strong compliance with sustainability and regulatory standards.
